Home / Pebsteel News: Latest Updates in Steel Solutions / Steel Building Insights / Metal Building: The Complete Global Buyer’s Guide (2026)

Metal Building: The Complete Global Buyer’s Guide (2026)

Steel Building Insights - 19/05/2026

If you need a durable, cost-efficient structure for a warehouse, factory, logistics hub, or commercial facility — a pre-engineered metal building is almost certainly the right answer. Construction timelines are 40–60% faster than reinforced concrete, costs are typically 20–30% lower, and the structural design life exceeds 50 years. This guide covers everything: structural systems, global cost benchmarks, engineering standards by region, corrosion considerations for tropical and coastal climates, and the step-by-step procurement process.

1. What Is a Metal Building?

A metal building — also called a pre-engineered metal building (PEMB), pre-engineered steel building (PESB), or steel building system — is a structure whose primary load-bearing system is factory-fabricated from structural steel components: tapered I-section columns, rafters, cold-formed purlins and girts, and profiled steel cladding panels. All components are designed and produced in a controlled factory environment, then shipped as a complete kit for rapid bolt-up assembly on the project site.

The term ‘metal building’ covers a wide spectrum — from a small agricultural shed to a 200-metre-wide multi-span manufacturing complex. What unites them is the same core principle: engineering-led factory prefabrication that compresses on-site construction time, reduces waste, and delivers a predictable structural outcome.

Modern building utilising Pre-Engineered Metal Buildings (PEMBs)

2. Types of Metal Building Structural Systems

Choosing the correct structural system is the most important early decision in a metal building project. The three principal systems are:

System Description Max Clear Span Best For
Clear-Span Rigid Frame Single-bay frame with no interior columns. Tapered primary rafters and columns carry all loads. Up to ~128 m Warehouses, aircraft hangars, sports halls
Multi-Span Frame Two or more bays with interior columns. Reduces frame weight but interrupts floor space. Up to ~150 m total (multi-gable up to ~360 m) Large manufacturing plants, distribution centres
Modular / Lean-to Attached single-slope extension to an existing main frame. Cost-effective for added office or storage space. Typically <30 m Office annexes, covered walkways, material storage
Single-Slope Frame One-sided pitched roof. Good for sites with height restrictions on one boundary. Up to ~80 m Retail, truck depots, equipment sheds

Clear-Span vs Multi-Span: How to Choose

The clear-span system maximises usable floor area by eliminating all interior columns — the preferred choice for warehouses requiring wide racking aisles or forklift circulation. Multi-span designs introduce interior columns but dramatically reduce steel tonnage on very wide footprints, cutting both material costs and foundation loads. For spans beyond 60 m, the multi-span system is almost always the more economical choice unless operations genuinely require column-free space.

Clear span frames in warehouse construction

Multi gable frame in warehouse construction

3. Key Components of a Metal Building

A complete pre-engineered metal building system comprises three structural tiers and a range of accessories:

Primary structural frame: Built-up tapered I-section columns and rafters, welded from high-tensile steel plate (typically ASTM A572 Gr. 50 or equivalent). These carry all gravity and lateral loads to the foundation.

Secondary structural members: Cold-formed Z- or C-section purlins (roof) and girts (walls), typically G550 galvanised steel. They support the cladding and transfer wind loads back into the primary frame.

Roof and wall cladding: Profiled steel sheets — single-skin corrugated, trapezoidal (IBR), or insulated sandwich panels (IMP). Coating options include Zincalume (AZ150), PVDF-painted, or proprietary high-durability systems for aggressive environments.

Accessories: Ridge and eave ventilation, gable and corner trims, gutters and downpipes, framed openings for roller doors, personnel doors, windows, and roof lights. Accessories have a disproportionate impact on weather-tightness and aesthetics.

READY TO BUILD?

Get a free engineering consultation and itemised quotation from PEB Steel’s team of 100+ structural engineers.

  →  Request a Free Quote ←

32+ years  |  50+ countries  |  100+ in-house engineers  |  AISC-designed buildings

4. Metal Building vs Other Construction Methods

The table below compares pre-engineered metal buildings against the three most common alternative construction methods for industrial and commercial projects:

Criterion Metal Building (PEMB) Reinforced Concrete Conventional Structural Steel Tilt-Up Concrete
Construction speed Fast (4–6 months typical) Slow (10–18 months) Medium (6–10 months) Medium-fast (5–8 months)
Relative cost (structure only) Low–Medium Medium–High Medium Low–Medium (large footprints)
Clear-span flexibility Excellent (up to 128 m) Limited Good Fair
Design flexibility / expandability High — bays can be added Low Medium Low
Maintenance requirements Low Medium (cracking, spalling) Low–Medium Medium
Multi-storey capability Limited (commonly up to 7 floors) Excellent Excellent Limited
Suitability for tropical/coastal climates High (with correct corrosion spec) High High (with correct spec) High

5. Metal Building Applications by Industry

Pre-engineered metal buildings serve virtually every sector of the industrial and commercial economy. The most significant applications include:

Warehouses and Logistics Centres

Metal buildings are the global standard for warehouse construction. Clear-span widths of 40–90 m allow double-deep racking at 11-metre heights, while standard bay spacings of 6–9 m align with ISO pallet dimensions and forklift turning radii. Fast construction allows rapid operational deployment — critical for e-commerce fulfilment operators.

smart logistics distribution in Indonesia

Manufacturing and Production Halls

Factories demand adaptability. Pre-engineered steel buildings can integrate overhead crane runway systems (up to 100+ tonnes), heavy-duty concrete floor loadings, process ventilation openings, and future-phase expansion bays — all designed into the primary structure from day one.

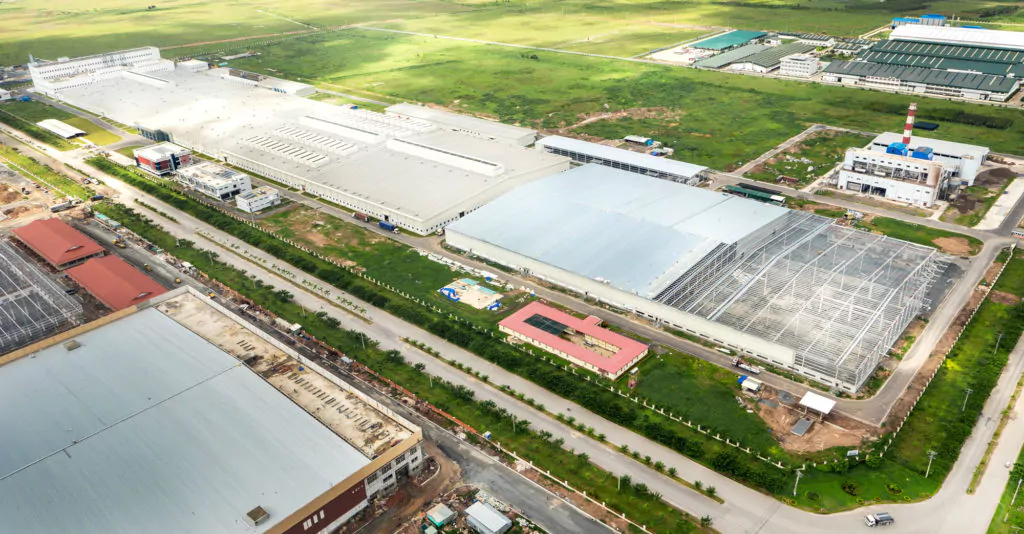

prefabricated steel product hall project by Pebsteel

Cold Storage and Controlled Atmosphere Facilities

Insulated metal panel (IMP) cladding with polyurethane or PIR cores achieves thermal performance values (U-values) below 0.25 W/m²K without the thermal bridging inherent to conventional construction. Metal buildings therefore form the structural backbone for cold chain facilities serving food processing, pharmaceutical, and horticultural industries.

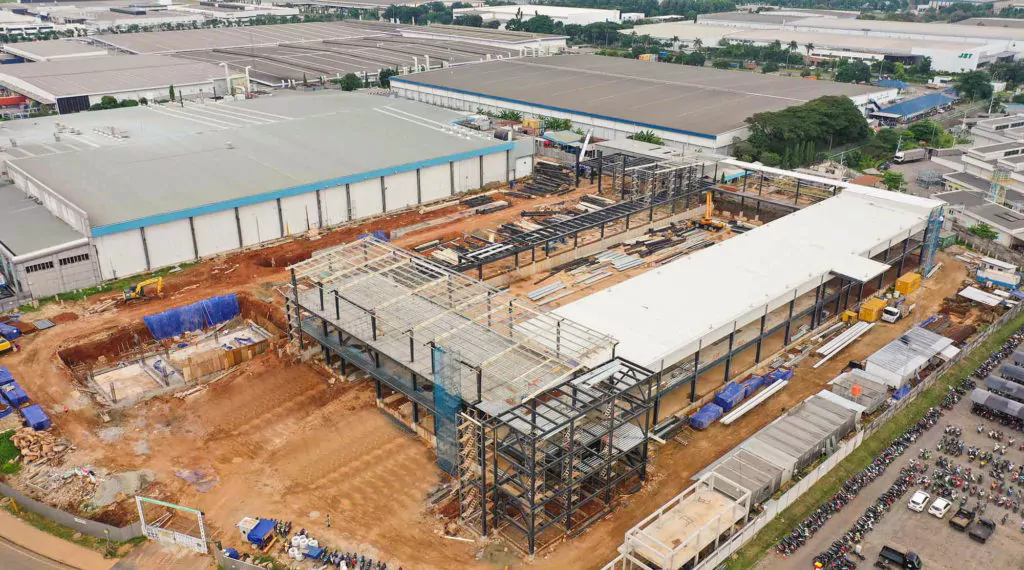

Xây dựng Kho Lạnh Indonesia 2018 - Steel Structured Indonesia Cold Storage Project 2018

Aviation Hangars and MRO Facilities

Aircraft maintenance, repair, and overhaul (MRO) hangars demand clear-span widths of 60–90 m with clearance heights of 10–20 m — parameters that suit the clear-span rigid frame system almost exclusively. Steel is also the only viable material for the complex geometries required by bifold or sliding hangar door systems.

Custom-designed pre manufactured steel hangar with large clear-span steel structure

Commercial and Retail

Shopping centres, big-box retail stores, and exhibition halls use pre-engineered steel for long-span roof structures — typically with concrete or masonry infill walls for the building envelope. This hybrid approach delivers structural efficiency alongside the aesthetic versatility demanded by retail brands.

19-storey 3 tower residential & commercial building in Philippines

6. Metal Building Costs: What Drives the Price

The cost of a metal building depends on the project rather than on a standard rate per square metre. The main drivers are:

  • Span and height: wider clear spans need heavier tapered frames; each extra metre of eave height adds column steel and wind load.
  • Crane loading: heavier columns, extra bracing and runway beam design.
  • Corrosion specification: a C4/C5-rated galvanised or high-performance coating costs more but is non-negotiable for coastal or chemical environments.
  • Insulation: glass wool blanket is the lower-cost option, insulated sandwich panels cost more but perform far better thermally and acoustically.
  • Fit-out and accessories: roller doors, skylights, ventilation and guttering are often underestimated, so include them from the start.
  • Foundation: not included in the kit price and dependent on site geotechnical conditions.

For a project-specific cost estimate, send your requirements through the contact form.

READY TO BUILD?

Get a free engineering consultation and itemised quotation from Pebsteel’s team of 100+ structural engineers.

  →  Request a Free Quote ←

32+ years  |  50+ countries  |  100+ in-house engineers  |  AISC-designed buildings

7. Engineering Standards by Region: What Governs Metal Building Design?

One of the most significant content gaps in existing metal building guides is the absence of region-specific engineering standards information — essential for international buyers procuring structures for projects outside North America. The table below maps the primary structural steel codes by region:

Region Primary Steel Standard Load / Wind Code Notes for Buyers
USA AISC 360, MBMA Metal Building Systems Manual ASCE 7 PEMB industry’s home market; most cost data is USD-based here
Europe EN 1993 (Eurocode 3) EN 1991 (Eurocode 1) National Annexes modify load factors by country
Australia / NZ AS 4100 / NZS 3404 AS/NZS 1170.2 (wind), .5 (seismic) NCC Part B1 governs structural adequacy; ShedSafe® for sheds
Southeast Asia AISC 360 (widely adopted) / TCVN (Vietnam) / SNI (Indonesia) ASCE 7 or national equivalents Typhoon wind zones (Philippines, Vietnam) require careful ASCE 7 wind region classification
Middle East / GCC AISC 360 / SBC (Saudi), ADIBC (Abu Dhabi) ASCE 7 / local codes Low seismic risk generally; extreme wind (haboob) and thermal loads are the key design considerations
Japan JIS G 3101 / AIJ Recommendations BCJ seismic standard High seismic zone; moment-frame design adds significant cost

Pebsteel designs to AISC 360, with IBC and ASCE as its international design basis, and to AS/NZS 1170 for projects in Australia and New Zealand. Buyers should always specify the governing code in the RFQ — it affects frame weight, connection design, and ultimately project cost.

8. Corrosion Considerations: Protecting Your Metal Building in Aggressive Environments

Corrosion is the most common cause of premature metal building degradation — and the most frequently underspecified element in international procurement. ISO 12944 defines six corrosion categories (C1–C5 + CX) based on the environmental aggressiveness:

Category Environment Description Typical Locations Recommended Coating System
C2 Low corrosivity — dry inland Rural Vietnam, inland Middle East Primer + topcoat (70–80 µm DFT)
C3 Medium — urban/industrial Industrial estates, urban SEA Epoxy primer + polyurethane topcoat (120+ µm DFT)
C4 High — coastal (>1 km from sea) Manila Bay area, Da Nang, Dubai coast Zinc-rich epoxy primer + epoxy intermediate + PU topcoat (200+ µm); AZ150 cladding
C5 Very high — marine / aggressive industrial Seaports, petrochemical plants, <500 m from sea Hot-dip galvanising (HDG) + duplex coating; Hyper180® (AZ180 + PVDF) or higher-specification cladding

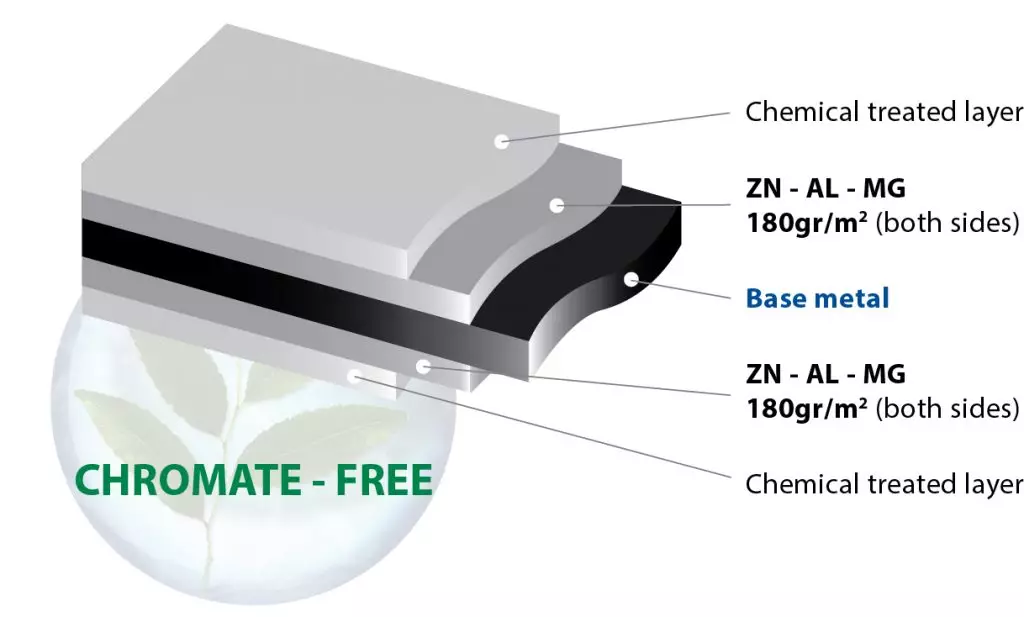

Pebsteel’s Hyper180® cladding system combines a 180 g/m² zinc-aluminium alloy coating (AZ180) with a PVDF colour coat, designed for severe corrosion environments (salt, alkaline, fertilizer, chemical) with no colour change for 20 years. For C5-rated facilities (port warehouses, coastal industrial plants), Pebsteel recommends the full HDG + duplex coating system on the primary frame, combined with Hyper180® cladding.

More about: Corrosion Protection for Pre-Engineered Steel Buildings

9. The Metal Building Procurement Process: From RFQ to Handover

International buyers unfamiliar with the pre-engineered building supply chain frequently encounter costly delays and scope gaps due to an unclear procurement process. The following eight steps outline the industry-standard process used by Pebsteel:

  • Step 1 — Define the building brief: Specify the gross floor area, clear height, span requirements, functional loads (floor load, crane capacity if any), location (for wind/seismic/snow data), governing structural code, and timeline.
  • Step 2 — Issue an RFQ to qualified suppliers: Provide the brief plus a site layout plan. Request itemised pricing for supply-only (CIF) and turnkey (erected) options. Require that quotes reference specific structural codes and corrosion specifications.
  • Step 3 — Technical evaluation of bids: Compare frame steel tonnages, cladding specifications, connection and anchor bolt details, and scope inclusions/exclusions. Low-tonnage bids are not always better — under-designed frames create costly site problems.
  • Step 4 — Detailed engineering and design: Once a supplier is selected, the engineering team produces detailed structural drawings, anchor bolt plans, and connection details for client approval. This phase takes 2–4 weeks for standard buildings.
  • Step 5 — Foundation design and construction: The client or their civil contractor installs the reinforced concrete foundation using anchor bolt templates supplied by the building manufacturer. This work typically proceeds concurrently with fabrication.
  • Step 6 — Fabrication and quality control: Primary frames are fabricated in the factory under controlled conditions. NDT (magnetic particle or dye penetrant testing) is performed on welds per the applicable AWS D1.1 or equivalent standard.
  • Step 7 — Shipping and site delivery: International projects require careful coordination of import documentation, customs clearance, and delivery sequencing. Components are numbered and packed in erection sequence.
  • Step 8 — Erection and handover: A trained erection crew (supplier-provided or client-appointed) assembles the building. Final inspections, bolt torque checks, and caulking/sealant application complete the scope. As-built documentation is issued.

Typical Project Timeline by Phase

Phase Typical Duration Notes
Design & engineering 2–4 weeks Complex or large buildings may take longer
Fabrication 6–12 weeks Concurrent with foundation works
International shipping + clearance 2–6 weeks Varies significantly by destination port
Site erection 2–8 weeks Depends on building size and crew size
Total typical project duration 4–7 months vs 10–18 months for comparable RC structure

More about: How to compare Pre-Engineered Steel Building Quotes

10. Sustainability and Green Building: Metal Buildings and ESG

Sustainability considerations are increasingly decisive in capital project approvals — yet almost no existing metal building guide addresses them. Pre-engineered steel buildings have significant environmental credentials that buyers should understand:

  • Steel recyclability: Structural steel is 100% recyclable at end of life. Globally, approximately 86% of structural steel is recycled into new steel products, making it one of the most circular construction materials available.
  • Reduced construction waste: Factory prefabrication eliminates the on-site concrete formwork, timber shuttering, and off-cuts typical of conventional construction. Site waste is typically reduced by 60–80%.
  • LEED and Green Star credits: Pre-engineered steel buildings can contribute to LEED v4, BREEAM, and Green Star certification through materials credits (recycled content), construction waste management credits, and energy efficiency credits via high-performance insulated panels.
  • Environmental Product Declarations (EPDs): Several major steel coil and structural steel producers now publish ISO 14025-compliant EPDs, enabling precise carbon footprint calculations for project-level sustainability reporting.
  • Solar-ready roofs: The standing-seam and trapezoidal profile roofs standard on metal buildings are ideal substrates for flush-mounted solar PV arrays. Pre-engineered buildings increasingly serve as the structural host for rooftop solar — a growing trend in Southeast Asia and Australia.

PEBSTEEL FACTORY ACHIEVES LEED GOLD CERTIFICATION - REAFFIRMING OUR COMMITMENT TO SUSTAINABLE DEVELOPMENT

11. How Pebsteel Designs and Delivers Metal Buildings

Pebsteel is a One-stop provider from design and fabrication to installation for Pre-engineered Steel Building and Steel Structure headquartered in Vietnam, founded in 1994, with 32 years of operational experience and more than 6,000 buildings delivered across 50+ countries.

In-House Engineering Capability

With more than 100 in-house structural engineers, Pebsteel handles the complete design cycle — from initial structural concept and load analysis through detailed shop drawings and connection design — using AISC 360 as the primary design code. SAP2000 is used for primary frame analysis; Tekla Structures for 3D detailing and clash coordination. Strumis for fabrication management and Idea Statica for connection design.

Manufacturing Infrastructure

Pebsteel operates six factories in Vietnam producing primary frames, secondary members, and ancillary steel components, with capacity above 100,000 metric tonnes a year and 15,000 tonnes of steel in reserve.

Proprietary Products

Hyper180® cladding system: A high-durability roof and wall panel system with a 180 g/m² zinc-aluminium alloy coating (AZ180) and PVDF colour coat, designed for severe corrosion environments with no colour change for 20 years. More about: Hyper180® Product Features

Multi-span up to ~150 m: Pebsteel‘s multi-span frame capability supports total building widths up to ~150 m, and multi-gable frames up to ~360 m— covering the full spectrum from standard 30 m single-span warehouses to the largest multi-span distribution centres.

Crane-integrated buildings: Pebsteel designs and delivers complete crane-integrated building systems including runway beam design, end stops, and crane cable management — for cranes up to 300 tonnes.

More about: Crane Buildings: The Complete Design, Load & Procurement Guide for Pre-Engineered Steel Structures

12. Real Project Examples

The following examples illustrate Pebsteel’s metal building delivery across different building types and project conditions:

Automobile Factory — Vietnam (Vinfast).

A 133,812 m² factory built to a strict project schedule, which required Pebsteel’s factories to work at 150% capacity for five months in a row to stay on track with the general construction timeline. Pebsteel also optimised the use of materials and adapted the details to the climate conditions on Cat Ba island, and fabricated the steel frames with a 20% higher strength resistance than the original design.

Aircraft Hangar — Philippines (Lufthansa Hangar).

A 6,000 m² aircraft hangar built with Pebsteel’s 128 m wide clear-span frame, the widest clear span Pebsteel has delivered. The structure lets many large aircraft be accommodated inside at the same time for mechanical maintenance. Pebsteel also supplied the sliding door system for the hangar.

Green Industrial Complex — Vietnam (Taekwang Vina Factory).

An 85,000 m² factory, the first green industrial complex required to meet specific LEED® requirements. Pebsteel chose PebLeed™ for the roof, PebInsul™ for the insulation and specially designed wall and roof ventilation systems, which promote energy saving and lessen factors that contribute to air, water and land pollution.

READY TO BUILD?

Get a free engineering consultation and itemised quotation from Pebsteel’s team of 100+ structural engineers.

  →  Request a Free Quote ←

32+ years  |  50+ countries  |  100+ in-house engineers  |  AISC-designed buildings

Frequently Asked Questions (FAQ)

What is a metal building?

A metal building (also called a pre-engineered metal building or steel building) is a structure whose primary load-bearing system consists of factory-fabricated steel components — columns, rafters, purlins, and cladding — assembled on-site. They are used across industrial, commercial, and agricultural applications worldwide.

How much does a metal building cost per square metre?

Metal building costs vary by project: span, height, design loads (wind, seismic, crane), cladding and insulation, corrosion specification, site location and logistics all affect the price. For a project-specific cost estimate, send your requirements through the contact form. Always request a detailed itemised quote covering primary structure, cladding, foundation, and erection.

What are the main types of metal building structural systems?

The three main structural systems are: (1) Clear-span rigid frame — column-free interiors up to ~128 m wide, ideal for warehouses and aircraft hangars; (2) Multi-span frame — interior columns added to reduce steel weight for very wide footprints up to ~150 m (multi-gable frames up to ~360 m); (3) Modular / lean-to buildings — used as extensions or low-cost ancillary structures. The right choice depends on clear height requirements, crane loads, and span width.

How long does a metal building last?

A properly designed, fabricated, and maintained metal building has a structural design life of 50 years or more under most international codes (AISC 360, EN 1993, AS 4100). Painted or Zincalume-coated roof and wall panels are typically specified for a coating service life of 20–30 years. Pebsteel’s warranty commitments are 2 years for materials, 3 years against leaks and 10 years for the structure.

What international standards govern metal building design?

The primary standards differ by market: AISC 360 and MBMA (USA, widely adopted globally); EN 1993 Eurocode 3 (Europe); AS 4100 / AS/NZS 1170 (Australia and New Zealand); JIS G 3101 (Japan). For seismic design, ASCE 7, EC8, or NZS 1170.5 apply depending on location.

What is the typical timeline from order to handover?

For a standard industrial metal building: design and engineering (2–4 weeks), fabrication (6–12 weeks), shipping and import clearance (2–6 weeks for international projects), and site erection (2–8 weeks). Total project durations of 4–6 months are common — roughly 40–60% faster than comparable reinforced-concrete construction.

Are metal buildings suitable for tropical and coastal climates?

Yes, but corrosion protection must be correctly specified. In tropical and coastal environments (ISO corrosion categories C3–C5), the structural steel frame should be hot-dip galvanised or primed with a zinc-rich epoxy system. Roof and wall panels should use AZ150 (150 g/m² zinc-aluminium) or higher coatings. Pebsteel’s Hyper180® cladding system is designed for severe corrosion environments, with no colour change for 20 years.

More about: Roof & Wall Insulation Systems for Pre-Engineered Steel Buildings

Can a metal building incorporate an overhead crane?

Yes. Pre-engineered metal buildings can be designed to accommodate overhead travelling cranes from 1-tonne hoists to 100+ tonne capacity bridge cranes. The primary frame must be sized for the additional crane runway beam loads, dynamic impact factors, and lateral surge forces at the design stage. Pebsteel has extensive experience designing crane-equipped production halls and maintenance facilities.

Disclaimer: The content provided in this article is for reference purposes only. For further details or clarification based on your needs, please contact Pebsteel directly.



READY TO BUILD?

Get a free engineering consultation and itemised quotation from Pebsteel’s team of 100+ structural engineers.

  →  Request a Free Quote ←

32+ years  |  50+ countries  |  100+ in-house engineers  |  AISC-designed buildings

logo-switcher

Local websites

Head Office - Export Sales

Sales Office - Cambodia

Sales Office - Thailand

Sales Office - Philippines

Sales Office - Indonesia

Sales Office - Chinese

Sales Office - Japanese

Global website

Learn all about Pebsteel, our worldwide solutions and projects.

Global website
logo

Global website

Learn all about Pebsteel, our worldwide solutions and projects.

Global website
